Water Main Replacement Program

Construction Project Template

Status

50%
  • Get Alerts

Project Phases & Updates

Completed phase

Project Committed

Completed phase

Project Advertised

March 18, 2026

Completed phase

Project Awarded

April 16, 2026

Construction Begins

July 13, 2026

Temporary Water Installed

July 27, 2026

Water Main Installation Complete

October 2, 2026

Water Services Installation Complete

October 2, 2026

Temporary Water Removed

October 9, 2026

Paving Complete

October 16, 2026

Final Restoration Complete

May 28, 2027

Attachments

No attachments found.

Description

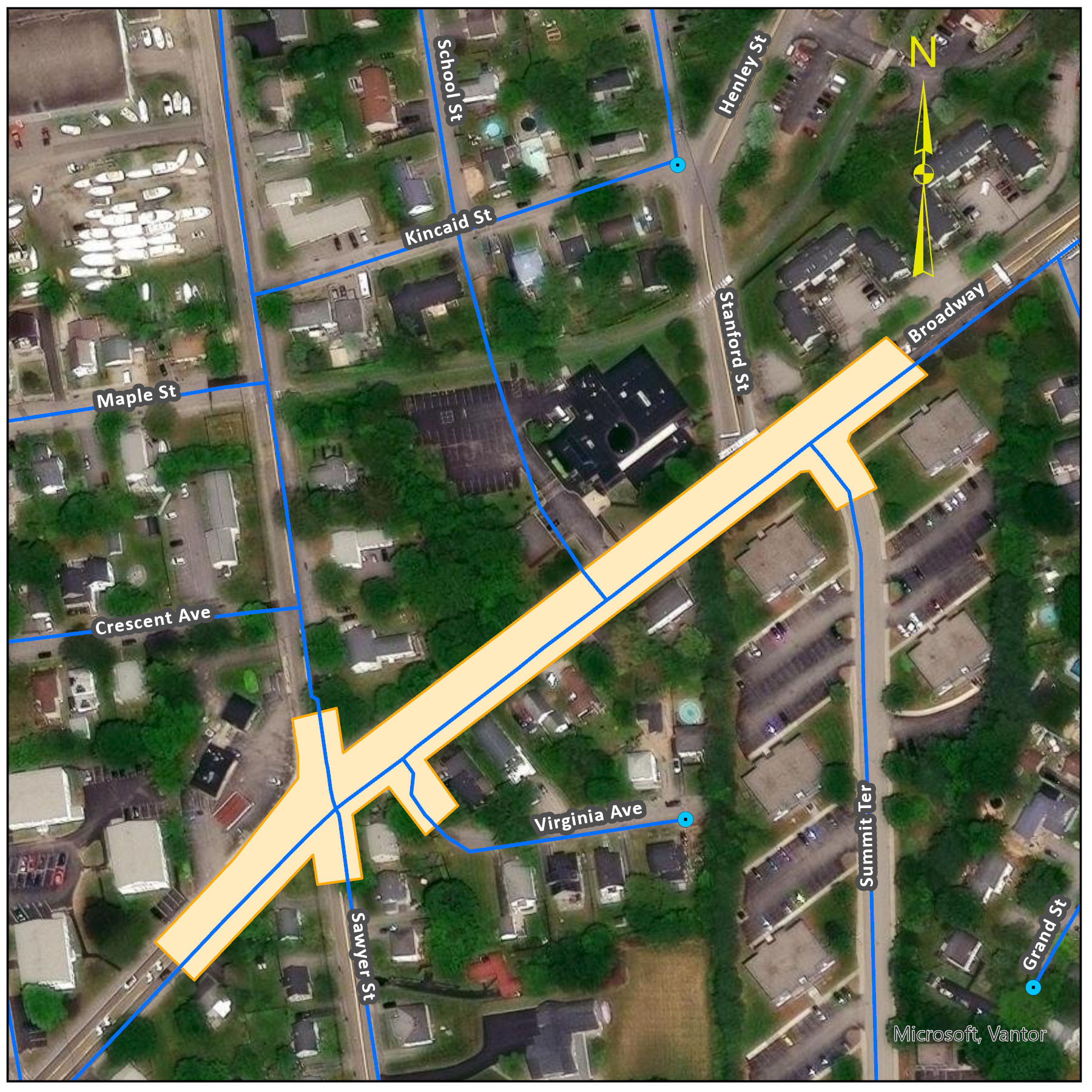

This project includes installation of around 950-ft of ductile iron water mains ranging in size from 4-inch to 12-inch in Broadway, Sawyer Street, and Virginia Avenue in South Portland. These new mains will replace undersized 2.25-inch cast iron (installed 1952), 6-inch cast iron (1892), 8-inch cast iron (installed 1902-1904), and 12-inch cast iron (installed 1922-1931) mains in these roads, complete a 12-inch loop started in 2024 in Sawyer Street, and will be completed in advance of paving by the City planned for 2027. x

Project Manager

Adam Sellick

Contractor

EnerSite

Project Updates

July 8, 2026

Work on the project is planned to begin Monday, July 13th.

Status

50%
  • Get Alerts

Project Timeline

Completed phase

Project Committed

Completed phase

Project Advertised

March 18, 2026

Completed phase

Project Awarded

April 16, 2026

Construction Begins

July 13, 2026

Temporary Water Installed

July 27, 2026

Water Main Installation Complete

October 2, 2026

Water Services Installation Complete

October 2, 2026

Temporary Water Removed

October 9, 2026

Paving Complete

October 16, 2026

Final Restoration Complete

May 28, 2027
